PERT Formula Examples & PERT Calculator

Three-point estimation and the PERT formula are two of the most widely used methods in project management for estimating the completion time of a project. While both approaches rely on three time values, including optimistic, most likely, and pessimistic, they differ in how they weight those values to arrive at a final estimate.

To help make these concepts easier to understand, we have included several detailed examples and explanations below.

What Is the 3-Point Estimation Formula?

The 3-point estimation approach calculates the expected duration or cost of a project task by taking a simple average of three scenario-based values. The formula can be expressed as:

Estimation = (Optimistic + Most Likely + Pessimistic) / 3

This method, also known as triangular distribution, treats all three values equally, making it a quick and straightforward technique that works well when your team needs a fast, collaborative estimate without complex calculations.

What Is the PERT Formula?

The PERT (Program Evaluation and Review Technique) formula improves upon the simple average by overweighting the “most likely” value, which reflects the reality that most outcomes cluster around the expected scenario rather than the extremes. The formula is expressed as:

Estimation = (Optimistic + 4 ร— Most Likely + Pessimistic) / 6

By multiplying the most likely estimate by four and dividing the total by six instead of three, the PERT formula produces a more balanced and statistically reliable estimate, particularly for complex or high-stakes projects.

Why Use 3-Point Estimation and the PERT Formula?

Lengthy project timelines and unclear estimations can cause significant tension and frustration among team members and stakeholders. Nobody likes feeling left in the dark about how a project is progressing, especially when there is potential for delays or budget overruns. Inaccurate estimates are one of the leading causes of missed deadlines, strained relationships, and failed project outcomes across every industry.

Whether you are managing a software development sprint, a construction project that requires tools like a Construction Loan Calculator to keep your budget on track, or a large-scale organizational initiative, accurate time and cost estimates are critical to keeping everyone aligned. Using the PERT formula and 3-point estimation gives your team a structured, data-informed way to forecast timelines, surface risks early, and set realistic expectations. The result is less unnecessary stress, greater team confidence, and a sharper focus on what matters most โ€” the successful completion of your project.

How to Use the PERT Formula to Estimate Project Completion Time

The PERT formula calculates the expected time to complete a project or task by taking a weighted average of three time estimates. These three values represent the full range of possible outcomes and are defined as follows:

  • O = Optimistic: The shortest realistic time to complete the task if everything goes smoothly.
  • M = Most Likely: The most realistic time estimate based on past experience and typical conditions.
  • P = Pessimistic: The longest time the task could take if significant obstacles or delays occur.

Once you have gathered these three values, you plug them into the following formula:

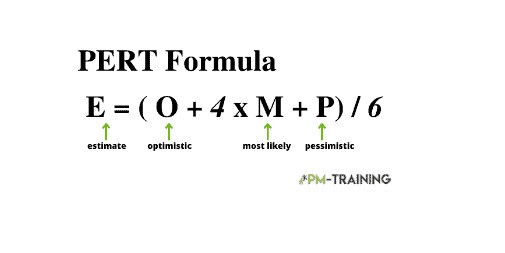

PERT = (Optimistic + 4 ร— Most Likely + Pessimistic) / 6

The result gives you a single, weighted expected duration that leans toward the most likely scenario while still accounting for best- and worst-case possibilities.

PERT Formula Example

Imagine you are the Project Manager of a software development team recently assigned to build an e-commerce website for XYZ Co. Based on your experience and knowledge of the project scope, you estimate that the website will most likely take 9 weeks to develop. In an optimistic scenario, where everything goes according to plan, you believe it could be completed in 7 weeks. In a pessimistic scenario, accounting for potential setbacks, you estimate it could take as long as 11 weeks.

How many weeks should this project take using the PERT formula?

Given values:

  • Most Likely (M): 9 weeks
  • Optimistic (O): 7 weeks
  • Pessimistic (P): 11 weeks

Applying the formula:

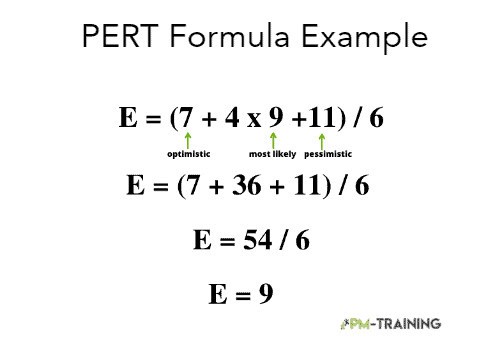

PERT = (7 + 4 ร— 9 + 11) / 6 PERT = (7 + 36 + 11) / 6 PERT = 54 / 6 PERT = 9 weeks

In this case, 9 weeks is the PERT-verified estimated project duration. The result aligns with the most likely estimate because the optimistic and pessimistic values are symmetrically distributed around it. In real-world scenarios, these values are often asymmetric, which is precisely where the PERT formula’s weighted approach adds the most value.

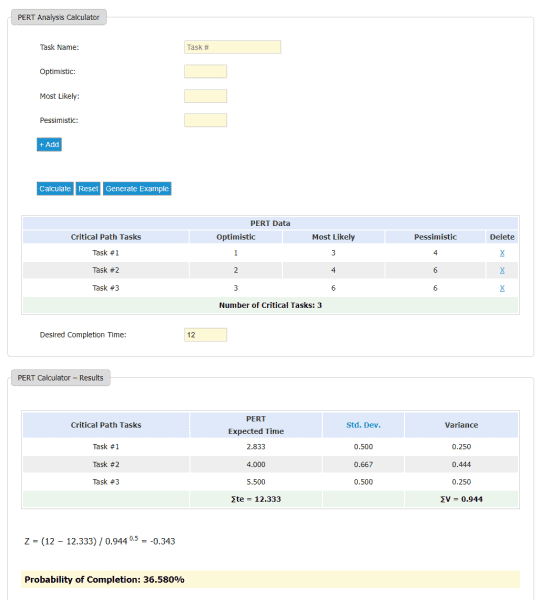

PERT Formula Calculator

If you prefer to skip the manual calculation, several free online PERT calculators are available to help you quickly compute expected durations. One reliable option is the PERT Calculator available at Good Calculators, which allows you to input your three values and instantly receive your weighted PERT estimate.

PERT Calculator โ€“ Good Calculators

Advantages of Using the PERT Formula

There are several compelling reasons why project managers across industries rely on the PERT formula as part of their estimation toolkit.

  • First and foremost, the PERT formula improves the accuracy of project estimates by ensuring that the most realistic scenario is given the greatest weight, rather than treating all three values equally.
  • It also helps identify potential risks and issues early in the planning process, giving teams more time to develop mitigation strategies before problems escalate.
  • Additionally, the PERT formula supports better resource management by providing a more reliable timeline that teams and stakeholders can plan around.
  • It also improves communication between team members and external stakeholders by establishing a shared, data-backed understanding of expected project duration.

When used consistently, the PERT formula is an extremely effective tool for ensuring projects are completed on time and within budget.

How to Calculate the 3-Point Estimation Technique

The 3-point estimation technique is a collaborative project management method used to estimate the value of a project component โ€” such as its cost or duration โ€” when uncertainty exists around that component’s outcome. Like the PERT formula, the 3-point approach uses three scenario-based values: optimistic, pessimistic, and most likely. However, unlike PERT, this technique is designed to be highly collaborative, encouraging team members to contribute their own estimates rather than relying solely on the project manager’s judgment.

The technique uses what is known as a triangular distribution, drawing on historical project data and the direct expertise of the people closest to the work. By incorporating multiple perspectives, the 3-point estimation method tends to produce estimates that are more grounded in operational reality, making it particularly effective for teams with strong institutional knowledge of the project domain.

The formula is:

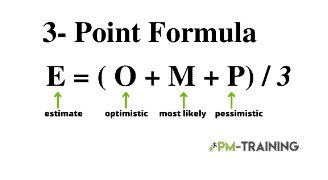

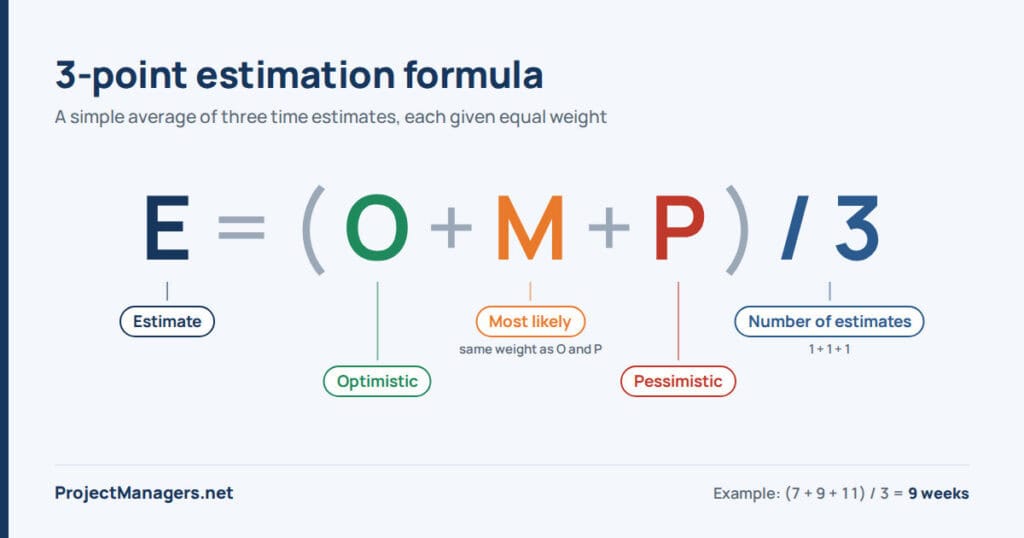

E = (Optimistic + Most Likely + Pessimistic) / 3

3-Point Estimation Example

Using the same scenario as before โ€” your software development team building an e-commerce website for XYZ Co. โ€” you ask your team to collectively estimate the project timeline using the 3-point formula.

Given values:

  • Optimistic (O): 7 weeks
  • Most Likely (M): 9 weeks
  • Pessimistic (P): 11 weeks

Applying the formula:

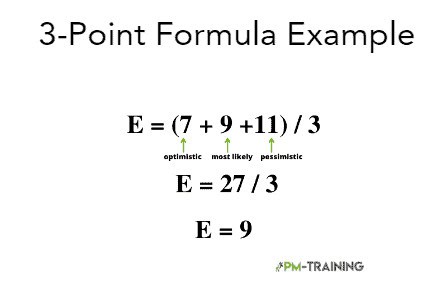

E = (7 + 9 + 11) / 3 E = 27 / 3 E = 9 weeks

In this example, 9 weeks is also the result of the 3-point estimation formula. As with the PERT example, the symmetrical distribution of values produces the same outcome. In practice, however, the two methods will often yield different results when the optimistic and pessimistic estimates are not equally spaced around the most likely value, which is common in real-world projects.

Advantages of the 3-Point Estimation Technique

The 3-point estimation technique offers several distinct advantages that make it a popular choice among project managers.

  • First, it is a simple and easy-to-understand method that requires no advanced statistical knowledge, making it accessible to teams at all levels.
  • Second, it is relatively accurate because it incorporates the hands-on expertise of team members who are closest to the work, resulting in estimates that reflect real operational conditions rather than abstract assumptions.
  • Third, the technique is highly flexible and can be adapted to estimate the cost, duration, or complexity of nearly any type of project component, regardless of industry or project size.

PERT Formula vs. 3-Point Estimation

Project estimation is one of the most challenging and consequential tasks in project management. The estimates generated during planning form the foundation for scheduling, budgeting, and resource allocation โ€” which means errors at this stage can have significant downstream effects on the entire project. Both the PERT formula and 3-point estimation are powerful tools for producing more reliable estimates, and understanding when to use each one is key to effective project planning.

The PERT formula, derived from the beta distribution, produces a more precise estimate by heavily weighting the most likely scenario. It is especially effective when used alongside the Critical Path Method (CPM), helping project managers identify the longest sequence of dependent tasks and develop tighter estimates when budgets or timelines are constrained.

Three-point estimation, based on triangular distribution, is better suited for collaborative estimation sessions where team input is prioritized and a straightforward, easy-to-explain formula is preferred. It works particularly well when estimating the cost or duration of an entire project’s Work Breakdown Structure (WBS) with broad team participation.

It is important to remember that both methods are estimation tools โ€” they reduce uncertainty but do not eliminate it entirely. Every estimate carries some degree of inherent risk, and both techniques should be paired with regular monitoring and adjustment throughout the project lifecycle.

Key Differences Between 3-Point Estimation and the PERT Formula

3-Point EstimationPERT Formula
DistributionTriangular: E = (O + M + P) / 3Beta: E = (O + 4M + P) / 6
WeightingAll three values weighted equallyMost likely value is weighted 4ร—
Best Used ForCollaborative team estimation across entire project cost or WBSUsed alongside CPM when budget or time constraints are tight
ComplexitySimpler and more accessibleCollaborative team estimation across the entire project cost or WBS

Other Project Estimating Techniques

Beyond 3-point estimation and the PERT formula, several other widely used project estimation techniques are available to project managers. The right technique should be selected based on the type of project, the amount of historical data available, and the level of precision required. Each method has its own set of strengths and limitations, so it is important to understand the context in which each performs best.

The most commonly used project estimation techniques include analogous estimating (also known as top-down estimating), which draws on the cost or duration of similar past projects; parametric estimating, which uses statistical relationships between project variables; bottom-up estimating, which builds a total estimate by summing detailed estimates for individual components; and the Critical Path Method (CPM), which focuses on identifying the sequence of tasks that determines the minimum project duration.

Is Three-Point Estimation Parametric?

Whether the three-point estimation method qualifies as a parametric technique is a question that continues to generate debate among statisticians and project management professionals. The three-point estimation method is a statistical technique used to estimate unknown parameters by assuming those parameters follow a particular probability distribution โ€” a characteristic that is central to parametric methods.

Some statisticians argue that this makes it inherently parametric, while others contend that its reliance on subjective team input and triangular distribution places it outside the strict definition of parametric estimation. At present, there is no clear consensus on this classification, and the debate remains ongoing in both academic and professional circles.

Differences Between Parametric and Analogous Estimating

Analogous estimating and parametric estimating are both widely used techniques for estimating the cost or duration of a project, but they differ significantly in their approach. Analogous estimating bases its projections on the known cost or duration of similar past projects, making it a fast and practical method when detailed data is unavailable.

Parametric estimating, by contrast, uses the statistical relationship between specific project variables โ€” such as cost per unit or hours per deliverable โ€” to calculate estimates with greater precision. Parametric estimating tends to be more accurate when reliable historical data and clearly defined variables are available.

PERT Formula Example Video

Conclusion

Accurate project estimation is not just a technical exercise โ€” it is one of the most important foundations of successful project management. The PERT formula and 3-point estimation technique both provide structured, proven approaches to moving beyond guesswork and developing estimates that are grounded in realistic scenario planning. While the PERT formula delivers a more statistically weighted result that is ideal for complex, high-stakes projects and Critical Path Method analysis, the 3-point estimation technique excels in collaborative environments where team input and simplicity are priorities.

Used together or independently, both methods help project managers reduce uncertainty, improve stakeholder confidence, and set their teams up for success from the very first phase of planning. As you build your project management toolkit, mastering these two estimation techniques will give you a significant advantage in delivering projects on time, within budget, and to the standard your stakeholders expect. The goal is never to eliminate uncertainty; it is to understand it well enough to plan around it effectively.

PERT Formula FAQs

What is PERT used for in project management?

The PERT formula is used to estimate the expected duration of project tasks and the overall project timeline. It helps project managers identify the critical path โ€” the sequence of tasks that determines the minimum possible project duration โ€” and pinpoint potential bottlenecks that could delay completion. By producing a more granular, weighted estimate, PERT enables better scheduling, more informed risk management, and stronger stakeholder communication throughout the project lifecycle.

What are the disadvantages of using PERT and 3-point estimation?

While both the PERT formula and 3-point estimation are valuable tools, it is important to recognize that they are still estimates and not guarantees. Every estimate involves some degree of uncertainty, and the accuracy of both methods depends heavily on the quality and realism of the three input values. If the optimistic, most likely, or pessimistic values are poorly defined or overly influenced by bias, the resulting estimate will reflect those inaccuracies regardless of the formula used.

Why is it important to use the 3-point estimation technique?

The 3-point estimation technique is important because it systematically reduces the risk of producing inaccurate, single-point estimates by incorporating a range of possible outcomes. This approach improves the overall accuracy of project planning, helps teams anticipate resource needs more effectively, and provides a more realistic picture of the project’s schedule. It also fosters greater team ownership and accountability by involving members directly in the estimation process.

What are the advantages of the 3-point estimation technique?

The 3-point estimation technique allows project teams to leverage their collective expertise and draw on historical project data to produce more reliable, commitment-backed estimates. By incorporating best-case, worst-case, and most-likely scenarios, the method surfaces a realistic range of outcomes that supports stronger planning decisions. It also encourages open dialogue among team members, which improves collaboration and builds shared understanding of the project’s complexity and risks.

What is the difference between analogous and parametric estimating?

Analogous estimating is based on the cost or duration of similar past projects and is best used early in a project when limited detailed information is available. Parametric estimating, on the other hand, uses the statistical relationship between project variables โ€” such as cost per square foot or hours per feature โ€” to calculate more precise estimates. Parametric estimating is generally more accurate than analogous estimating but requires a larger body of reliable historical data to produce meaningful results.
